A Practical Guide to Calculating Earned Value
Calculating earned value gives you a real-time health check on your project’s budget and schedule. Think of it as a GPS for your project: it doesn’t just show you where you are, but also tells you if you’re on the right track to reach your destination on time and on budget.
Simply tracking hours and costs isn’t enough. You have to know what you’ve actually earned for that spend, and that’s where this powerful technique comes in. Let’s walk through how it works, using some real-world examples to make it click.
Why Earned Value Is Your Project’s Health Check
If you’ve ever run a project for a professional services firm, you know the feeling. The team is logging hours, tasks are getting checked off, but that nagging question lingers: are we actually making progress, or just spinning our wheels? Simply comparing hours spent against the total budget doesn’t tell you the whole story.
That’s where Earned Value Management (EVM) comes in. It’s not just another layer of bean-counting; think of it as a powerful diagnostic tool. It moves you beyond guesswork and gives you concrete answers to your most critical project questions.
The Three Pillars of Earned Value
At its core, calculating earned value rests on three straightforward but incredibly powerful metrics. Getting a handle on these is the first step to unlocking true project insight.
Here’s a quick rundown of the foundational metrics you absolutely need to know.
Core Earned Value Metrics at a Glance
| Metric | What It Means | The Question It Answers |
|---|---|---|
| Planned Value (PV) | Your baseline—the budgeted cost for work scheduled by a specific date. | “Where did we plan to be?” |
| Earned Value (EV) | The value of the work actually completed to date, measured against the budget. | “What have we accomplished?” |
| Actual Cost (AC) | The total cost incurred to complete the work so far. | “How much have we spent?” |
Comparing these three numbers gives you an immediate, unbiased look at your project’s true status. It’s the difference between just looking at your car’s fuel gauge (Actual Cost) and also knowing your miles-per-gallon and estimated arrival time (Earned Value). To take a deeper dive into profitability, check out our guide on improving your firm’s financial performance.
Earned Value isn’t about tracking the past; it’s about understanding the present to accurately predict the future. It’s your early warning system for budget overruns and schedule delays, giving you time to correct course before minor issues become major problems.
This isn’t some new-fangled theory. While EVM’s roots go back to the early 1900s, it was formally adopted by the U.S. Department of Defense in the 1960s. Its value has been proven time and again since then. One study even showed that projects using EVM were 20% more likely to meet their budgets. You can explore more about the history of earned value management to see how it has evolved. This is exactly why it’s such an indispensable tool for protecting your firm’s bottom line.
Calculating the Three Core Earned Value Metrics
Alright, let’s roll up our sleeves and get into the numbers. This is where the magic really happens with EVM. Calculating earned value isn’t some complex algebra problem; it’s about asking three fundamental questions and using simple formulas to get the answers. We’ll break down each of the core metrics—Planned Value (PV), Earned Value (EV), and Actual Cost (AC)—with a practical example you can actually relate to.

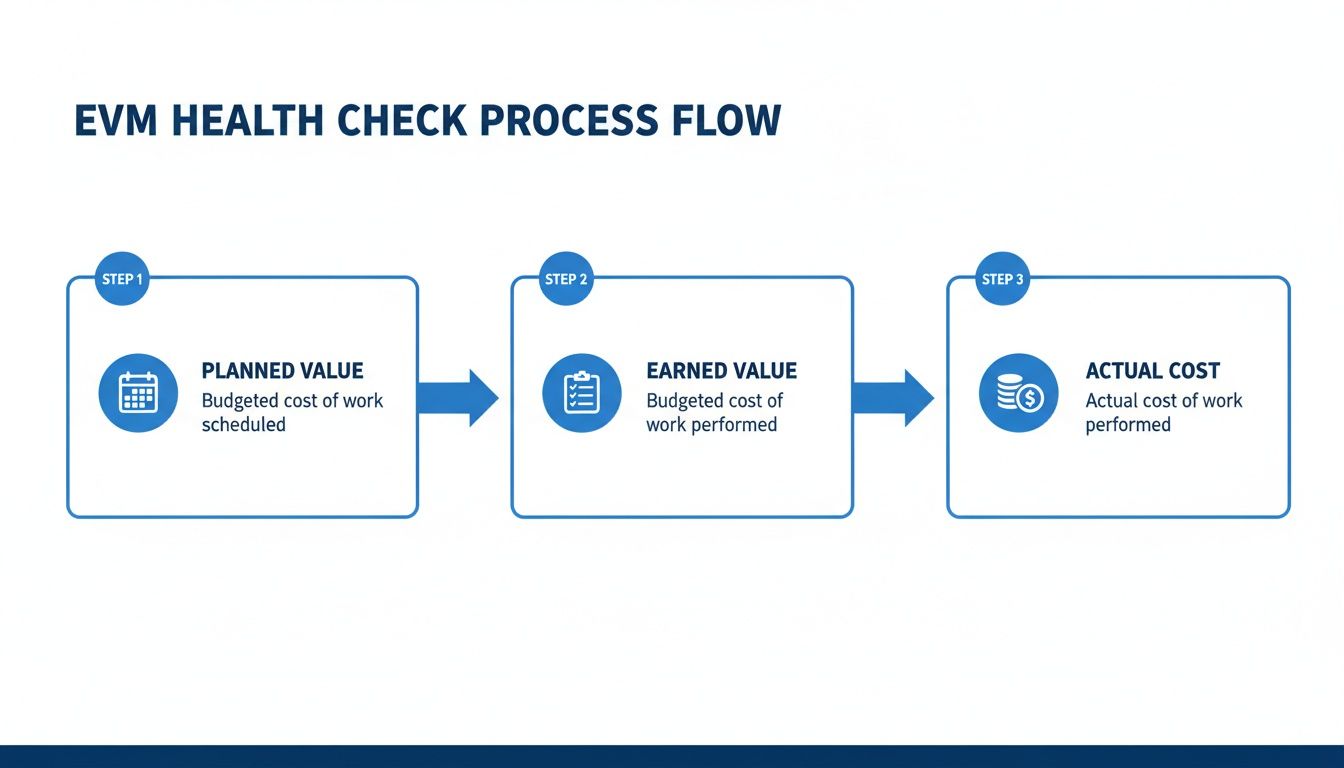

This quick process flow shows how these three metrics are the building blocks for a complete project health check.

As you can see, it all starts with your plan (PV). Then you measure that against your actual progress (EV) and finally compare it to what you’ve really spent (AC).
Planned Value (PV) The Baseline
First up is Planned Value (PV). Think of this as the authorized budget for the work you scheduled to have done by a certain date. In plain English, it’s where your project should be, according to the original plan. It answers the question, “How much work did we plan to have done by now?”
The formula is wonderfully straightforward:
PV = (Planned % Complete) x (Budget at Completion)
Let’s run with an example. Imagine your architecture firm is tackling a schematic design phase with a total budget of $40,000. The phase is set to last four weeks. At the end of week two, your project plan says you should be 50% complete.
- PV = 50% x $40,000 = $20,000
So, at the two-week mark, your Planned Value is $20,000. This number is your benchmark—the value you’ll measure everything else against.
Earned Value (EV) The Reality Check
Next is Earned Value (EV), which measures the value of the work you’ve actually completed so far. This is probably the most insightful metric of the three because it directly connects your team’s progress to the budget. It answers the crucial question, “How much value have we actually delivered?”
Here’s how you calculate it:
EV = (Actual % Complete) x (Budget at Completion)
Sticking with our architecture project, let’s say that at the end of week two, the design team has only finished 40% of the schematic design work, not the planned 50%. Maybe they hit a small snag, and things are running a bit behind schedule.
- EV = 40% x $40,000 = $16,000
Your Earned Value is $16,000. You’ve “earned” $16,000 of the project’s budget based on the work you’ve knocked out, even though the plan said you should have earned $20,000 by now.
Actual Cost (AC) The Bottom Line
Finally, there’s Actual Cost (AC). This one is the most direct—it’s the total cash you have actually spent to get the work done. No smoke and mirrors here. It simply answers, “How much did we spend to get to this point?”
There’s no fancy formula needed; it’s just a raw reflection of your expenses. To find your AC, you just need to add up all the project costs to date:
- Labor: All the hours your team has logged, converted to cost.
- Materials: Any direct costs for supplies, printing, or resources.
- Subcontractors: Invoices you’ve paid to external partners.
For our architecture project, let’s say after two weeks your timesheets and expense reports show you’ve spent a total of $18,000.
So, your AC is $18,000.
At this point, we have our three core numbers: PV = $20,000, EV = $16,000, and AC = $18,000. Just by looking at these, we can already see a story unfolding. We planned to get $20,000 worth of work done, but we only accomplished $16,000 worth, and it cost us $18,000 to do it.
With these three foundational metrics calculated, you now have the raw data needed to uncover much deeper insights into your project’s performance. We’ll dig into that next.
Translating Data into Action with CPI and SPI
Alright, you’ve done the groundwork and have your core metrics—PV, EV, and AC. Now it’s time to move from simple data collection to making powerful, informed decisions. This is where calculating earned value really starts to pay off.
We’re going to do this using two of the most important performance indicators in project management: the Cost Performance Index (CPI) and the Schedule Performance Index (SPI).
Think of these simple ratios as your project’s vital signs. They give you an instant, objective reading on your budget and timeline health. Instead of just looking at raw dollar variances, you can now see efficiency and progress in a standardized way.

Unpacking the Cost Performance Index (CPI)
The Cost Performance Index tells you exactly how efficiently your team is using its budget. In essence, it answers the question, “For every dollar we’ve spent, how much value have we actually earned?”
The formula is a straightforward division:
CPI = Earned Value (EV) / Actual Cost (AC)
Let’s jump back to our architecture project. We had an EV of $16,000 and an AC of $18,000.
- CPI = $16,000 / $18,000 = 0.89
So, what does that 0.89 actually mean? A CPI of 1.0 is the goal—it means you’re perfectly on budget. A number greater than 1.0 is fantastic; you’re under budget. A number less than 1.0, like our 0.89, signals you are over budget.
In our case, for every dollar we’ve put into this project, we’ve only earned 89 cents of value. It’s a clear, early warning that costs are creeping up faster than planned.
Gauging Your Pace with the Schedule Performance Index (SPI)
In the same vein, the Schedule Performance Index measures your progress against the project timeline. It answers the question, “Are we progressing at the rate we planned?” This metric is a lifesaver for spotting delays before they snowball into major problems.
Here’s the formula:
SPI = Earned Value (EV) / Planned Value (PV)
Using our example again, we had an EV of $16,000 and a PV of $20,000.
- SPI = $16,000 / $20,000 = 0.80
Just like with CPI, a value of 1.0 means you are right on schedule. An SPI greater than 1.0 means you’re ahead of schedule, while an SPI less than 1.0 indicates you’re behind. Our SPI of 0.80 tells us the project is progressing at only 80% of the planned rate.
With a CPI of 0.89 and an SPI of 0.80, we have a clear, data-backed story. The project is both over budget and behind schedule. This isn’t a moment for panic, but for proactive management. Now you can ask targeted questions: Did we underestimate the complexity? Is there a resource bottleneck?
This kind of early detection is invaluable. A comprehensive analysis of 51 real projects showed EVM forecasts using CPI were remarkably accurate, often within 10-20% of final costs. For professional services firms, this translates to tangible gains; those tracking EV often report 22% higher profitability from catching variances early. You can find more details on the effectiveness of EVM forecasting.
Of course, getting accurate Actual Cost data is foundational to these calculations. Reliable, easy-to-use time tracking software is non-negotiable, as it directly feeds the AC metric that drives your CPI. These insights empower you to make precise adjustments, turning potential disasters into manageable challenges.
Forecasting Project Outcomes With EAC and ETC
Knowing your project is over budget (CPI < 1.0) or behind schedule (SPI < 1.0) is a crucial first step. But the real power of Earned Value Management comes from using that current performance data to look into the future. It’s time to move from being reactive to proactive by forecasting your project’s final outcome.
This is where two key forecasting metrics come into play: Estimate at Completion (EAC) and Estimate to Complete (ETC). These calculations give you a data-driven prediction of your final project cost, allowing you to have honest conversations with clients and make strategic adjustments before it’s too late.
Predicting The Final Cost With Estimate at Completion (EAC)
Estimate at Completion is your new best guess for the project’s total cost. It takes your performance so far—good or bad—and uses it to re-forecast the budget.
While a few different formulas exist, the most common one assumes that the cost performance you’ve seen to date will continue for the rest of the project. It’s a simple, powerful reality check.
The formula is: EAC = Budget at Completion (BAC) / CPI
Let’s jump back to our architecture project. It had a total budget (BAC) of $40,000, and after two weeks, its CPI was a slightly worrying 0.89.
- EAC = $40,000 / 0.89 = $44,944
Based on the team’s current efficiency, the project is no longer on track to finish at the original $40,000 budget. Instead, it’s now forecasted to cost nearly $45,000. This is the number you can now manage toward.
Figuring Out The Remaining Cost With Estimate to Complete (ETC)
Once you know your new forecasted total (EAC), the next logical question is, “how much more money will we need to spend to get this done?” That’s exactly what Estimate to Complete tells you.
The formula for ETC is beautifully simple: ETC = EAC – Actual Cost (AC)
For our project, the EAC is $44,944 and the team has already spent (AC) $18,000.
- ETC = $44,944 - $18,000 = $26,944
This means you should expect to spend an additional $26,944 to complete the remaining work. This insight is incredibly valuable for resource planning, cash flow management, and client communication.
The Big Picture: With these forecasts, you’re no longer flying blind. You know the project is heading for a $4,944 budget overrun (a metric called Variance at Completion, or VAC). Now you can make decisions. Can you find efficiencies to lower the ETC? Do you need to discuss a change order with the client?
These forecasting capabilities transform earned value from a simple reporting tool into a strategic management asset. Integrating these calculations is a core function of robust professional services automation tools. You can learn more about how this works by exploring what is PSA software and how it centralizes your project data for better decision-making.
Integrating Earned Value into Your Daily Workflow
Theory is great, but putting it into practice is what really counts. The secret to making calculating earned value a sustainable habit—rather than a dreaded quarterly chore—is moving away from spreadsheets and into a live, automated system. It’s about building a workflow where data flows seamlessly from your team’s daily activities straight into your project’s health dashboard.
A solid workflow starts with setting up your projects correctly from day one. That means establishing a clear Budget at Completion (BAC) and a well-defined Work Breakdown Structure (WBS). Think of the WBS as your project roadmap; it’s where you break down massive deliverables into smaller, more manageable tasks or phases.

This setup creates a powerful, self-sustaining loop. When your team logs hours against these specific WBS tasks, that data automatically populates your Actual Cost (AC). When they mark a task as 50% complete, that update directly feeds your Earned Value (EV). This is exactly where a unified platform like Drum becomes so valuable, connecting time tracking, task management, and budgeting in real time.
Overcoming Common Hurdles
For professional services firms, one of the biggest challenges has always been objectively measuring progress on creative or intellectual work. It’s a fair question: how do you quantify “percent complete” on a strategy document or a complex design phase?
The solution is milestone-based tracking. Instead of relying on subjective guesses, you tie progress to tangible, agreed-upon deliverables.
- 25% complete when the initial client brief is approved.
- 50% complete after the first draft is delivered and reviewed.
- 90% complete once final revisions are submitted for approval.
- 100% complete when the project files are officially handed off to the client.
By defining these objective checkpoints at the project’s start, you remove ambiguity and ensure everyone is aligned on what “done” actually looks like.
By integrating these practices, you transform earned value from a complex calculation into an effortless, ongoing pulse check. The data you need is generated naturally through your team’s everyday work, giving you a constant, clear view of project health without the manual number-crunching.
This automated approach doesn’t just save countless hours; it dramatically improves the accuracy of your insights. Every logged hour and every completed task is connected directly to your firm’s financial performance, making proactive project management the new standard.
Common Questions About Calculating Earned Value
As firms start dipping their toes into earned value, a few common questions almost always pop up. This is especially true when you’re trying to apply these principles to the messy, nuanced world of professional services.
Let’s tackle some of the most frequent ones we hear.
How Do You Measure Percent Complete for Creative Work?
This is the classic challenge for any project that isn’t building widgets on a factory line. For creative, consulting, or design work, subjective guesses like “I feel like it’s 80% done” are a recipe for disaster. They’re unreliable and lead to misleading metrics.
The best approach is to anchor your progress to objective, milestone-based measurements that you define at the very start of the project. It removes all the guesswork.
For example, a marketing campaign plan could be structured this way:
- 20% complete after the initial discovery and kickoff meeting is signed off.
- 50% complete when the core strategy document and channel plan are delivered.
- 80% complete once creative concepts and initial copy are approved.
- 100% complete after all final assets are delivered to the client.
This method ties progress directly to tangible deliverables. Suddenly, your Earned Value calculation becomes far more accurate and, frankly, a lot more meaningful.
What Is the Difference Between EAC and BAC?
Think of it like planning a road trip.
The Budget at Completion (BAC) is your original plan. It’s the total budget you set aside before you even started the car. It’s a fixed target, and it shouldn’t change unless you decide to add a major detour (like a formal, approved scope change).
The Estimate at Completion (EAC), on the other hand, is your GPS recalculating the route mid-journey. It’s your new forecast of the total cost, updated in real-time based on your performance so far (your CPI).
If your project is running perfectly on budget (CPI = 1.0), your EAC will happily match your BAC. But if you’re hitting unexpected costs and running over budget (CPI < 1.0), your EAC will be higher than your BAC. It’s a realistic, data-driven heads-up that you’re heading for a potential budget overrun.
Is Earned Value Useful for Smaller Projects?
Absolutely. While EVM got its fame managing massive, complex government contracts, its principles are completely scalable. You could even argue they’re more critical for smaller, fast-moving projects. A small creative agency, after all, has much less room for budget slippage than a giant engineering firm.
On a small project, you don’t need a complex system. Simply tracking PV, EV, and AC gives you the same powerful, early-warning signals. It helps you answer the fundamental question: “Are we getting the value we planned for the time and money we’ve already spent?”
This discipline is what protects profitability. It helps you spot trouble when it’s still small enough to fix easily, ensuring even your quickest projects stay healthy and on track.
Ready to stop juggling spreadsheets and start making data-driven decisions?
Drum unifies your projects, time tracking, and financials into a single, intuitive platform. See how you can automate your earned value calculations and gain real-time visibility into project health.
Start your free 14-day trial and discover a better way to run your studio.
